Gantry Crane Buyer’s Guide for Industrial Lifting
Start with a full gantry crane when the load moves between fixed points and your site can support a ground runway on both sides. Consider a semi-gantry along a building wall if the elevated runway and its supports can carry the offered crane loads. Before comparing prices, mark where the hook must reach on a site plan. Send that plan to each supplier and compare the crane drawings against it.
An industrial gantry crane lifts with a hoist or trolley on a bridge supported by legs. This guide focuses on powered, rail-mounted cranes for fabrication shops, storage yards and production lines. A supplier can quote the right capacity and span while offering a hook that still stops short of a loading point.
Which gantry crane configuration should you quote?
Choose the support arrangement first. A full gantry needs two ground-level runways. A semi-gantry runs on a ground rail on one side and an elevated runway on the other. Where a building already has two suitable elevated runways and the floor needs to remain open, include an overhead crane in the comparison. Compare gantry and overhead crane layouts.
| Site or lifting requirement | Configuration to quote | What to check |
|---|---|---|
| General assembly, yard loading or stock handling between two ground rails | Single-girder gantry crane | Confirm that the offered hoist meets your lifting schedule and that the hook reaches every transfer point. |
| Repeated heavy lifts, a specialised lifting attachment or a layout that needs a different trolley to achieve the hook height | Double-girder gantry crane | Compare the proposed trolley, allowable duty, usable hook height and wheel reactions at your span. |
| One side of a bay has suitable building support for an elevated runway | Single-girder semi-gantry crane | Check the elevated support and the ground runway, then mark the moving leg’s path through the work area. |
Compare a box-girder and a truss gantry crane if your yard has a long span or significant wind exposure. Ask each bidder for its operating and parked wind limits, parking arrangement and reactions at the rails. Use those values to check which design suits the site.
Does the hook reach every pickup and set-down point?
Span is the distance between the two runway rail centrelines. To find the usable space for the hook centreline between the rails, deduct the hook’s approach distances shown on the supplier’s drawing. A truck may fit between the legs while its load centre sits beyond the trolley’s travel limit.
In this illustrative steel-yard layout, measure all points from the left rail centreline. The required positions are 2.0 m and 17.0 m. One bidder offers an 18.0 m rail-centre span, a 1.2 m left hook approach and a 1.5 m right hook approach.
| Drawing check | Result |
|---|---|
| Leftmost hook position | 1.2 m from the left rail centreline |
| Rightmost hook position | 18.0 m − 1.5 m = 16.5 m from the left rail centreline |
| Pickup at 2.0 m | Within the offered hook range |
| Set-down at 17.0 m | 0.5 m beyond the offered hook range |
With the same rail layout and transfer points, ask for a right hook approach of 1.0 m or less, or move the transfer point into the available range. If the transfer point must sit outside the rails, request a cantilever layout and verify the permitted load and hook position on that extension. In the plan and section views, also check long-travel end approach, clearance around legs, load envelope and the highest hook position needed to clear the load route.
Check horizontal hook reach between the rails
Enter the dimensions from the drawing in metres. Locate both required points from the left rail centreline.
Use the example above. The left travel limit is the left approach. Subtract the right approach from the span to find the right travel limit.
What does the civil contractor need from the crane supplier?
Give the civil designer the bidder’s wheel-load schedule, which shows the load each wheel applies to the runway under the specified conditions. Ask for wheel spacing, rail section, vertical and horizontal design actions, and applicable operating and parked load combinations. The crane’s rated lifting capacity describes the suspended load. The runway also supports the crane’s own weight and the changing wheel reactions as the trolley moves.
Agree who designs and installs the foundations, rails, stops and incoming power. For a semi-gantry, include the building-side support review. Set a date to confirm rail alignment, travel clearances and power connections before erection. Outside, put the crane’s operating wind limits and parking procedure in the handover documents. In the US, OSHA’s 29 CFR 1910.179 specifies wind indicators and automatic rail clamps for outdoor storage bridges. Have the bidder identify the requirements applicable to the offered equipment and your site.
What do 2026 gantry crane prices cover?
A supplier’s export guide based on January 1, 2026 steel prices publishes these two 10-ton equipment references. Both rows use 380 V, 50 Hz, three-phase power. The rows give span and lift height, with equipment type, duty, trade terms and site work to be confirmed on the project quote.
| Capacity as listed | Rail span | Lift height | Published equipment reference |
|---|---|---|---|
| 10 ton | 10 m | 8 m | US$15,000–16,400 |
| 10 ton | 8 m | 12 m | US$16,100–17,600 |
Use the closest layout as a starting point for the equipment budget. The two rows change both span and lift height. To see what additional lift costs for your site, ask one supplier to quote both lift heights at your fixed span, with the same duty, power supply and delivery scope. Compare gantry crane budget ranges and supply boundaries.
How do you compare the installed bids?
Only compare bidders after their drawings meet your load and coverage requirements. Give each bidder the same delivery point and ask for separate prices or responsibilities for the following work.
| Scope | What to get in writing |
|---|---|
| Crane equipment and controls | Bridge, legs, hoist or trolley, travel drives, controls, crane wiring and any lifting attachment |
| Runway and foundations | Design inputs, rail section and length, stops, support work, installation tolerances and survey sign-off |
| Power and site interfaces | Incoming supply, isolation, crane electrification and the physical handover point |
| Freight, unloading and erection | Packing, named delivery point, applicable trade term, local unloading and assembly |
| Testing and handover | Commissioning, test weights, inspection responsibility, operator training and records |
If one bid excludes the rails and they are necessary, get the rail price from the party doing that work and add it to the comparison. Apply the same approach to foundations, power and testing. Carry unresolved costs as open items until the contractor and price are known.

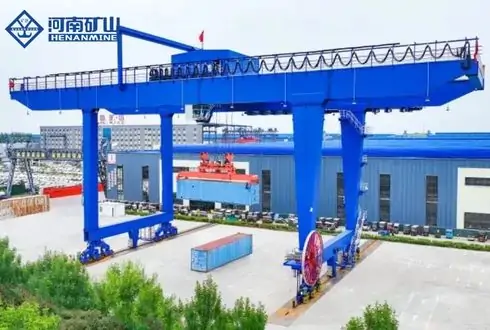

A 400-ton double-girder gantry crane in chemical equipment manufacturing
Henan Mine Crane’s project record reports a 400-ton double-girder gantry crane in use for chemical equipment manufacturing. The crane uses programmable logic control and variable-frequency drives, with a cab display that shows operating status. The project record describes those features in the context of the plant’s positioning requirements. See the 400-ton project record.
If accurate placement matters on your line, give bidders the load and attachment, the location of the fixture and the allowable placement error. Request the proposed low-speed control and an acceptance check performed with a representative load at a defined station. Agree on how the error will be measured and recorded before ordering.

What should you send with a gantry crane enquiry?
Send a marked-up site plan, a section drawing and the heaviest suspended load, including lifting beams, grabs, slings and any other removable lifting equipment. Include the typical loads and lifts per hour, the required hook elevations, indoor or outdoor conditions and the delivery location. Point out where you want the rail, power, assembly and test responsibilities to change hands.
Ask for a general arrangement drawing, wheel-load schedule and a quote with named responsibilities for the crane and site work. Request a gantry crane layout and quotation.
Frequently asked questions
Can I reuse my existing gantry rails?
A survey and engineering review can establish whether the rail section, geometry, supports and condition suit the new crane. Give the engineer the proposed wheel loads and wheel spacing, as well as the existing runway drawings and survey.
Can I keep a truck lane between the crane legs?
Ask for the clear opening between the moving legs and check it against the truck’s dimensions, manoeuvring space and the load envelope. Verify how the transfer area will be controlled during lifts and crane travel.
How do I describe duty when I have no specified class?
Send the expected load weights, lifts per hour, operating hours and shifts. Include how often the trolley and bridge travel. Ask the supplier to state its crane and mechanism classifications and the operating assumptions behind them.
When should I request spare-parts information?
Ask with the quote, while bidders can still identify the hoist, travel drives, brakes and controls they intend to supply. Request the part numbers and lead times for items whose failure could stop production.
